IN DESIGN
SCHOOL ADDITION

DAVID LEWIS PUBLIC SCHOOL

An eight-classroom addition and a 5-room Childcare at David Lewis Public School

Project Address: 130 Fundy Bay Blvd, Scarborough, ON M1W 3G1

TDSB is building an 8-classroom addition and a 5-room Childcare to address accommodation pressures at this school. The addition will also include interior renovations in the existing school to accommodate the new addition. The project will provide new modern classrooms spaces that will allow the school flexibility to manage current and future enrollment pressures.

Background

David Lewis PS is a JK to Grade 8 elementary school located in North-West Scarborough. The school currently has six portables on site.

A permanent addition was first identified as an emerging Capital Priority project for the TDSB in 2013. It was determined at that there were no opportunities to relocate programs or change boundaries to make additional room available within the school, and a new addition was required to accommodate the enrollment pressures and replace the existing portables.

In July of 2022 the Ministry of Education (EDU) provided capital funding approval to construct a new permanent addition and Childcare at David Lewis PS. In August of 2022, the Facility Space Template was approved by the EDU and allowed TDSB to begin the design process.

Objectives

Once completed the school community will benefit from the following:

  • Permanent classrooms adding 184 student capacity to the existing school.
  • Enhanced use of outdoor play areas by reinstating landscaping in areas occupied by portables.
  • Expanded affordable Childcare spaces that will provide economic opportunities for the community.
  • Facility modernization through renovations of existing spaces and addition of new classrooms and Childcare.

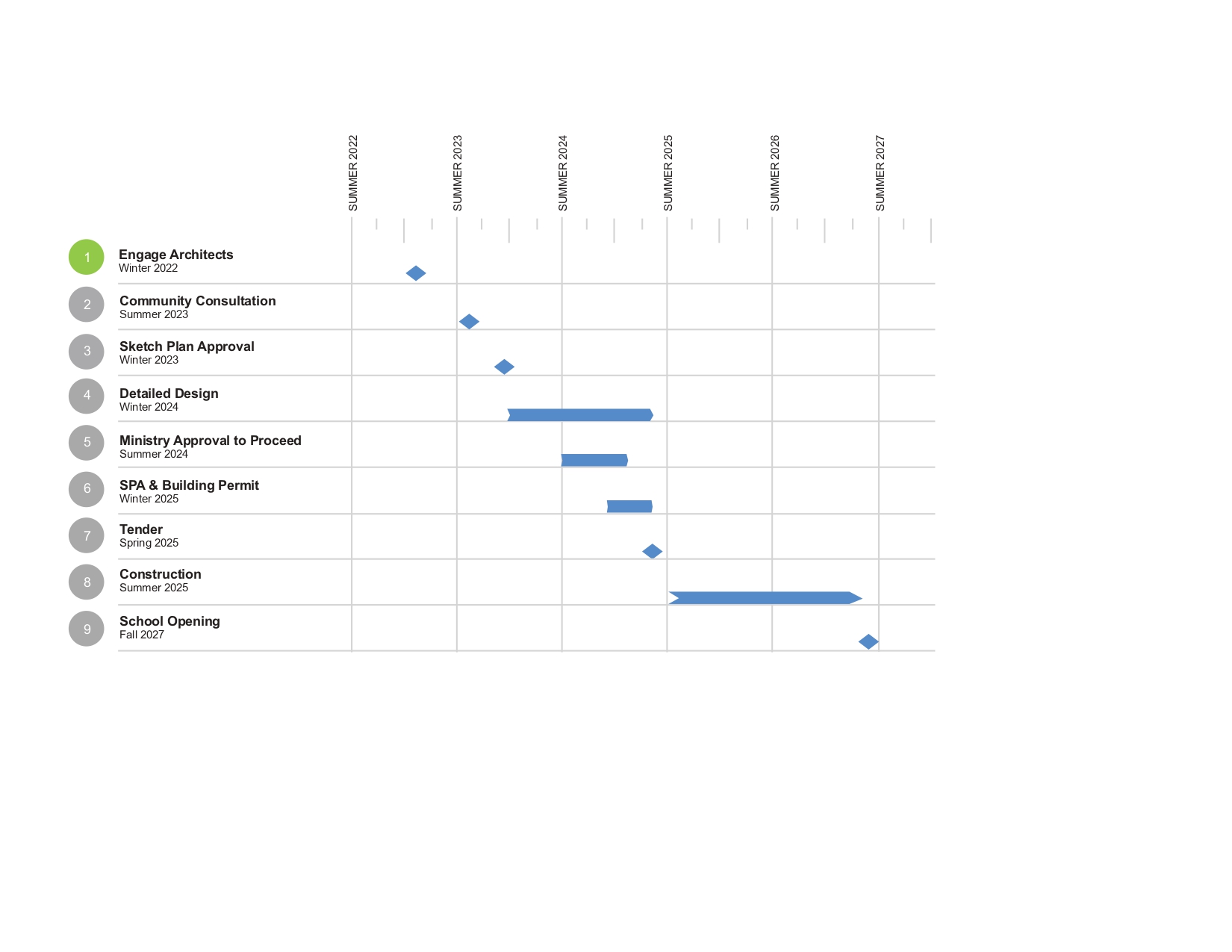

Milestone Schedule

Project Approval October 2020
Architect Procurement October 2023
New School Review Team August 2023
Schematic Design Approval November 2023
Site Plan Control June 2026
Building Permit TBD
Community Presentation TBD
Detailed Design TBD
Ministry Pre-tender Check-in TBD
Construction Tender TBD
Construction TBD
School Addition Opening Anticipated January 2030
Childcare Opening Anticipated September 2030
